Large corporations often face high-stakes decisions when considering investments in projects like new plants, high-rise condos, or major I.T. initiatives. How do they determine which projects are worth investing in?
Capital budgeting provides the financial framework to evaluate feasibility and compare potential investments.
When organizations generate profits, they can either reinvest in their existing operations or pursue expansion through capital expenditures. With multiple projects often vying for funding, and the “do nothing” option also competing in the mix (that is, avoiding the expenditure and increasing short term profits), capital budgeting methods help prioritize and guide these critical decisions. In this article, we will explore the three main approaches to capital budgeting, but first we have to establish some baselines relating to corporate profitability.
It’s all About Profit
At the end of the day, organizations have a bit of money left over (hopefully!), called profit. They have the option of either investing this back into their current business or carrying out expansion projects, called capital expenditures. Often there are multiple projects to choose from.

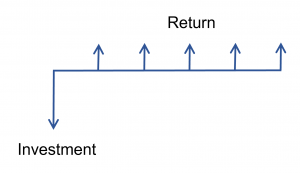

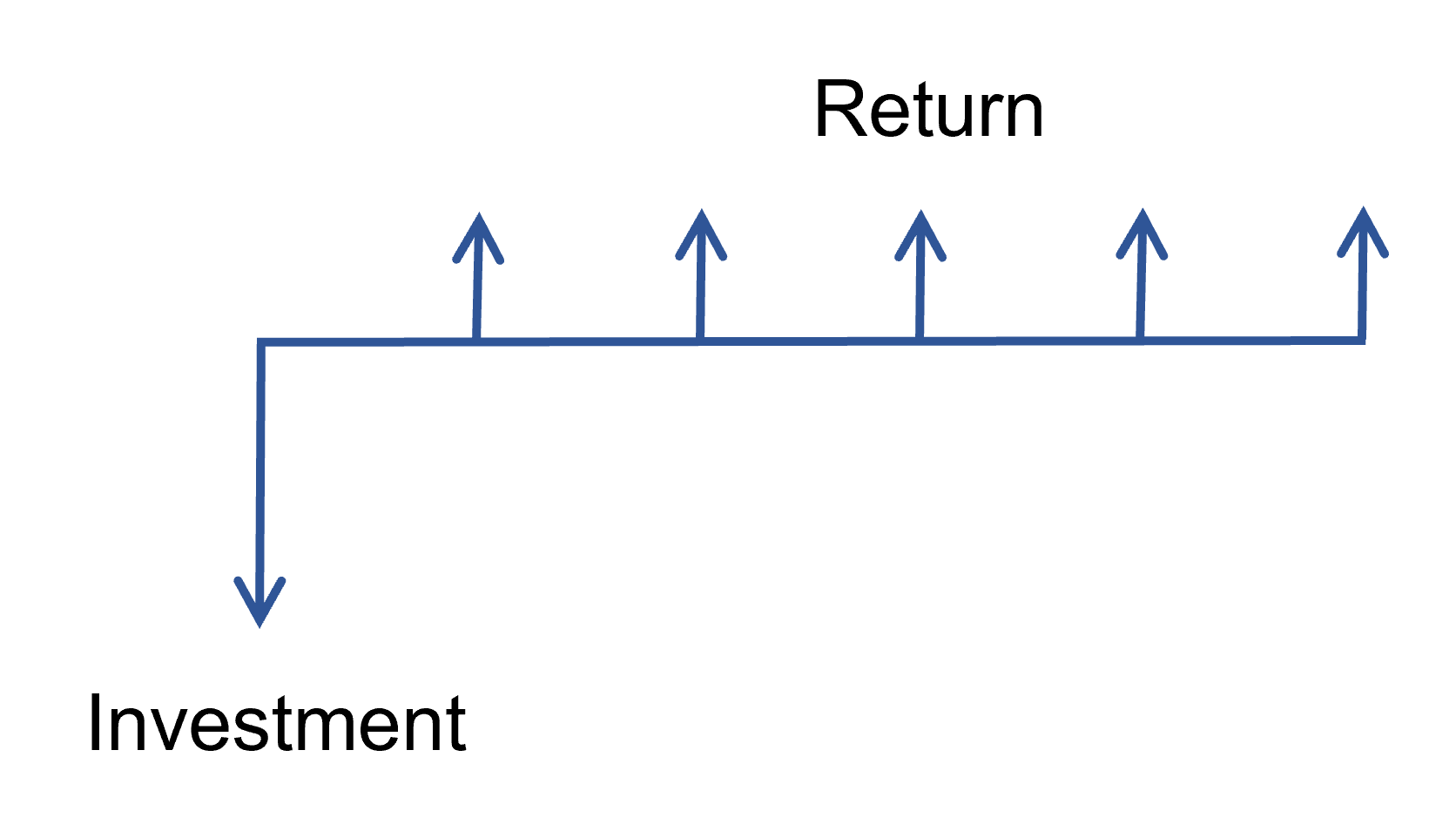

Usually, but not always, the potential investment incurs an expenditure at the beginning and generates an ongoing return, like this:
If the return is of an intangible nature, such as for an environmental project, road construction, or the like, a cost benefit analysis may be more appropriate.
Capital budgeting methods seek to assess the return on investment of the various alternatives with the goal of making a decision to proceed with one or more projects. The 3 main capital budgeting methods are:
- Net present value
- Internal rate of return
- Payback Period
Net Present Value (NPV)
NPV is ideal for evaluating long-term projects where initial costs are high, but benefits accrue over a long time period. It’s an excellent tool for businesses contemplating capital-intensive projects like new manufacturing facilities or technology upgrades, where the costs are largely up front and benefits are spread out over many years.

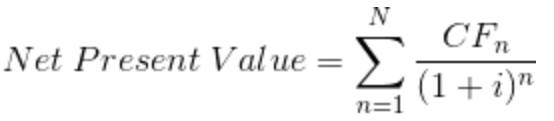

The net present value represents the value, in today’s currency, of all of the inflows and outflows generated by the project.
Every project represents a series of cash inflows and outflows. Due to the time value of money, an apples to apples comparison must be made between money received today and money received tomorrow. To make an investment decision, each future inflow/outflow is converted to today’s value using a discount rate.
The discount rate is more than the cost of inflation. It represents the opportunity cost, that is, the amount that the project must generate to compete with other projects that the organization could undertake. Even if there is only one project being considered, as a minimum the organization can borrow money and invest it back into the business at a fairly well known rate of return (the current business growth rate). New projects have to compete with that.
- The receipt of $100 today is worth $100 – it is not discounted
- The receipt of $100 in one year is discounted by the discount rate. Assuming the discount rate is 5%:

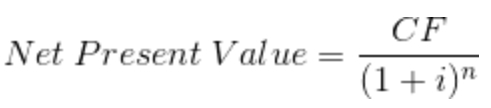

If a salesman proposes to pay your business $100 in one year’s time, it is equivalent to paying you $95.24 today. This is because your business is likely to turn that $95.24 into $100 within that time, throughout the normal course of business and taking into account monetary inflation. - The receipt of any one item of cash flow (CF) in any year is discounted by the formula:

- The whole stream of cash flows representing a project investment is discounted to the present one at a time:

- A payment is represented as a negative, for example, -$100, and treated in the same way.
If the net present value is positive (above zero) the project should be approved. If it is negative, the project should be rejected.
If multiple projects are being considered, the one with the highest NPV should be chosen.
Internal Rate of Return (IRR)
The Internal Rate of Return (IRR) shines in investment scenarios where you need to understand the profitability of investments with varying cash flow patterns over time. It’s particularly ideal when comparing projects of different scales or durations, like when a company is choosing between several potential projects with differing initial costs and expected returns. For instance, IRR is crucial in real estate development, where developers might look at projects involving different timelines for construction and sales.
IRR is the rate at which the NPV of the project is zero. In a spreadsheet it is calculated iteratively by setting up the NPV calculation and varying the discount rate until the NPV equals zero. For example,
Organizations have many places that they can deploy their profits. The excess funds generated from operations can be invested back into their operations, generating a rate of return similar to the previous activities that generated the profits in the first place. Or they could be invested into a capital project, expansion or new venture. Many organizations even have multiple capital projects that compete for the investment. But the return obtained by the funds that are invested into the existing operations is called the cost of capital. New projects must complete with this.
Further complicating matters is that the company can obtain debt financing to carry out the projects. The debt financing comes with a known (usually) interest rate.
Hence, the rate of return being obtained from existing operations is averaged with the interest rate on debt to obtain the weighted average cost of capital (WACC).
This WACC is the target.
- If IRR > WACC, the project should proceed
- If IRR < WACC, the project should be rejected (or revised).
The IRR might still be positive, but when it is less than the WACC the project does not represent an investment that is stronger than the company’s existing operations. Hence there are better places to invest the money.
The main drawback of IRR is that it assumes excess capital is reinvested at the project’s IRR, rather than the corporation’s cost of capital. Since this is unlikely, the IRR might be skewed in the direction of approving the project.
Payback Period
The NPV and IRR are fantastic indicators. They give the project an apples-to-apples comparison with other investment and project alternatives. But they are missing a critical piece. That is, they don’t take into account how quickly the investment is returned to its investors.
The payback period represents the amount of time in which the investment recoups its initial capital expenditure. It is the breakeven point of the investment.
NPV vs. IRR vs. Payback Period
For most projects, the NPV and IRR will generate the same accept/reject decision. However, their differences are in the timing and magnitude of the cash flows. NPV assumes that the cash inflows are reinvested at the cost of capital, whereas IRR assumes reinvestment at the project’s IRR. Hence, NPV tends to be a more conservative approach.

The payback period is a more qualitative indicator which can guide in decision making. Although the NPV and IRR quantify the investment in relation to other investments or projects, the payback period gives you a picture of how quickly the project returns the organization back to it previous financial position.
If you’ve ever been on the decision end of a megaproject, please let us all know about your thought process in the comments. I (we) would love to know what you went through and how you and your fellow decision makers justified the investment. But I’ve been on the engineering end of the process and I can assure you that getting your return on investment quickly is a big deal when handling complex, multidisciplinary megaprojects with high technical complexity. In short, imaginations run wild at the thought of the multitude of risks that can materialize during the construction and initial income phase of an average megaproject, prior to the payback point.
As a consequence, decision makers tend to like the payback period and some might even forgo a bit of IRR in order to see the money back in the bank quickly.
Capital Budgeting Example
Your division of the company has been given a Capex (capital expenditure) of $1 million to proceed with expansion projects. The weighted average cost of capital (WACC) for the corporation is 7%. You have determined 3 project options to choose from:
| Project | Capex | IRR | NPV | Payback Period |
|---|---|---|---|---|
| A | $1,000,000 | 35% | $1,450,000 | 2.3 years |
| B | $200,000 | 40% | $320,000 | 3.3 years |
| C | $800,000 | 12% | $845,000 | 4.7 years |
You can choose either Project A or Projects B and C together.
All three of the projects are above the WACC hence they will all benefit the company. Project B is clearly the most profitable, however is it the best decision? Projects B and C together would have a lower rate of return than project A, but are still above the WACC.
The answer is that you would choose project A because it utilizes the available funding with the maximum return.
